Category:

DPWH BEGINS FEASIBILITY STUDY FOR 25 PRIORITY BRIDGE PROJECTS ACROSS 11 REGIONS
Advancing the infrastructure development agenda of President Ferdinand R. Marcos Jr., the Department of Public Works and Highways (DPWH) is set to commence the feasibility study for the Urgent Bridges Construction Project for Rural Development (UBCPRD) Phase II — a major initiative designed to enhance inter-regional connectivity and promote inclusive economic growth across the Philippines.
Led by DPWH Secretary Manuel M. Bonoan, with the oversight of Senior Undersecretary Emil K. Sadain, who is in charge of Official Development Assistance (ODA)-funded infrastructure flagship projects under the Build Better More program, the feasibility study will be funded through Asian Development Bank (ADB) Loan No. 3886 – PHI (Infrastructure Preparation and Innovation Facility – Additional Financing) under a contract valued at ₱694.44 million.
The consulting services, scheduled to officially begin on June 7, 2025, will cover the feasibility study for the construction and/or replacement of 25 priority bridges across 11 regions, with a total estimated combined length of 18.78 kilometers of bridge and approach roads.
“By expanding bridge infrastructure with ten (10) in Luzon, six (6) in Visayas, and nine (9) in Mindanao, the project is expected to enhance transport efficiency, strengthen disaster resilience, and boost local economies —especially in remote and underserved areas. It also directly aligns with President Marcos’ national priorities of balanced regional development and modern infrastructure connectivity”, said Senior Undersecretary Sadain.
A formal kick-off meeting between DPWH Bridges Management Cluster – Unified Project Management Office (BMC-UPMO) under Project Director Rodrigo I. Delos Reyes, ADB, and the consulting consortium, composed of SMEC International Pty Ltd. (lead) in joint venture with Oriental Consultants Global Co., Ltd., COWI A/S, SMEC Philippines Inc., and associated with Pacific Rim Innovation and Management Exponents, Inc. (PRIMEX), was held Tuesday, June 3, 2025 to mark the start of the consulting services, following the approval of the Contract Agreement on May 9, 2025, and the issuance of the Notice to Proceed (NTP) on May 20, 2025, which was accepted by the consultant on May 28, 2025.
Other notable attendees of the kick-off meeting include ADB Transport Sector Group - South East Asia Department Director Dong Kyu Lee, SMEC International Pty, Ltd./OCG/COWI A/S JV Project Manager/Sr. Highway Engineer Gavin Strid, SMEC Philippines President and Country Manager Hilario M. Pastrana, UPMO-BMC Project Managers Nina Y. Maniaul and Judee Ann D.R. Santillan, and representatives of DPWH Planning Service, Bureau of Quality and Safety, Bureau of Design, Stakeholders Relations Service, and UPMO-Roads Management Cluster II (Multilateral).
The consulting consortium will carry out the feasibility study within the period of 24 months and will form the basis for the detailed design and construction phases of the project.
Priority bridges include conventional pre-stressed concrete girder (PSCG) bridges such as the Bacarra Bridge (parallel) in Bacarra, Ilocos Norte; Quirino Bridge (parallel) in Bantay, Ilocos Sur; Kalabaza-Villa Fugu Bridge and Lalog Bridge in Isabela; Alag Malaki Bridge (parallel) in Baco, Oriental Mindoro; Malitubog Bridge in Alamada, Cotabato; Simuay Bridge in Sultan Kudarat, Maguindanao; and the Talacogon Steel Bridge in Agusan del Sur.
The iconic cable-stayed bridge category includes the Buntun and Enrile bridges in Cagayan; the New Mancatian Bridge along the Angeles-Porac-Floridablanca-Dinalupihan Road in Central Luzon; the Daram-Talalora Bridge on Daram Island, Samar; and Wawa Bridge in Bayugan City, Agusan del Sur.
Also included are iconic arch bridges such as the Amnay Bridge in Sablayan, Occidental Mindoro; Araneta Bridge (new) in Bago City, Negros Occidental; Biliran Bridge (parallel) and Baliacao Bridge (parallel) in Eastern Visayas; Layog Bridge (parallel) in Mahaplag, Leyte; Calbiga Bridge in Samar; and Tamontaka Bridge in Cotabato City.
The lone iconic extradosed cable-stayed bridge is the proposed Manguisoc Bridge in Mercedes, Camarines Norte, while the iconic steel truss bridge is the new Butuan Bridge in Butuan City, Agusan del Norte. Rounding out the list are iconic arch truss bridges including Quezon Bridge in Dipolog City; Disakan Bridge 2 (new) in Sindangan; and Ingin Bridge in Manukan, all in Zamboanga del Norte.

DPWH HEEDS PBBM’S CALL FOR BETTER GOVERNANCE, PARTNERS WITH ADB AND DAP TO DEVELOP FUTURE LEADERS
Answering the call of President Ferdinand R. Marcos Jr. for public servants to become stewards of good governance, the Department of Public Works and Highways (DPWH) through the Unified Project Management Office (UPMO) has formalized a strategic partnership with the Asian Development Bank (ADB) and the Development Academy of the Philippines(DAP) to implement the Leadership Excellence for Advanced Development (LEAD) Program.
This initiative aims to cultivate a new generation of values-driven, competent leaders within the DPWH who are equipped with advanced management, leadership, and technical skills necessary to support the national government’s infrastructure thrust.
A ceremonial signing of the Memorandum of Understanding (MOU) and Letter of Agreement (LOA) was held on May 28, 2025, at the ADB Headquarters in Mandaluyong City. The event was led by DPWH Senior Undersecretary Emil K. Sadain, ADB Transport Sector Office Director Dong-Kyu Lee, and DAP Officer-in-Charge and Senior Vice President for Programs Magdalena Mendoza.
The LEAD Program is a strategic initiative aimed at ensuring leadership continuity and institutional sustainability in the implementation of the country’s transformative Infrastructure Flagship Projects (IFPs).
The DPWH IFPs are mostly under the Unified Project Management Office (UPMO) Operations and as designated by DPWH Secretary Manuel M. Bonoan are directly under supervision of Senior Undersecretary Sadain,.
In his message, Senior Undersecretary Sadain underscored the urgent need to train and develop highly capable individuals who can become the future leaders of the Department. He emphasized that these leaders must embody the ideals of a Bagong Pilipinas — committed public servants who are efficient, proactive, innovative, and dedicated to transformative public service.
The DPWH aspires to cultivate a corps of forward-looking leaders committed to public service excellence, innovation, and integrity —ensuring that the department remains a driving force behind inclusive and sustainable national development.
Through the LEAD Program, DPWH is equipping future leaders to sustain the momentum of national infrastructure efforts particularly UPMO-managed IFPs under Official Development Assistance (ODA) financing.
ODA-funded IPFs include: Bataan–Cavite Interlink Bridge linking Central Luzon and CALABARZON across Manila Bay; Panay–Guimaras–Negros Island Bridges improving inter-island connectivity in the Visayas; Davao City Bypass, Samal Island–Davao City Connector Bridge, and Bucana Bridge - enhancing mobility in the Davao Region; Dalton Pass East Alternative Road providing safer access to Cagayan Valley through mountainous terrain; Guicam Bridge (Zamboanga Sibugay) – Advancing connectivity in Mindanao; Second San Juanico Bridge – Strengthening the link between Samar and Leyte; Cebu-Mactan 4th Bridge and Coastal Road – Reducing congestion and improving access in Metro Cebu; Laguna Lakeshore Road Network Project – Promoting sustainable transport around Laguna de Bay; and Integrated Disaster Risk Reduction and Climate Change Adaptation (IDRR-CCA) Project – Addressing flooding and climate resilience in Central Luzon
ADB expressed its commitment by providing grant support for the LEAD Program through Technical Assistance No. 10084-PHI: Strengthening Infrastructure Capacity and Innovation for Inclusive Growth – Phase 2. Meanwhile, DAP will design and deliver the program, leveraging its expertise as the national government’s premier training and development institution.
Also present at the signing event were ADB officers Atty. Ruby Alvarez (Lead Project Officer – Infrastructure), Transport Specialist Juan Gonzales, and Consultant Sharon Baquiran. From the DAP, attendees included Vice President for the Center for Governance Imelda C. Caluen, Director for Operations Management Alvin P. Principe, Project Manager Merriam P. Dy, Project Coordinator Maria Eloisa Beatrice I. Encinas, and Mr. Joebert Sayson.
Representing the DPWH were Unified Project Management Office (UPMO) Project Directors Benjamin A. Bautista, Teresita V. Bauzon, Rodrigo I. Delos Reyes, Ramon A. Arriola III, and Soledad R. Florencio; Project Managers Shirley O. Castro, Zenaida B. Mauhay, Emmanuel M. Supe, Evangeline L. Carabal, and Shirley E. Medina; Program Manager Paula Kristina G. Gawat, Deputy Program Manager Engr. John Mark Guimba, and other key technical personnel.

DPWH, ADB, AND KEY AGENCIES CONDUCT JOINT INSPECTION OF R.T. LIM–SIOCON ROAD UNDER MINDANAO GROWTH CORRIDOR PROJECT
Officials from the Department of Public Works and Highways (DPWH), in collaboration with representatives from the Asian Development Bank (ADB), Department of Finance (DOF), and Department of Economy, Planning, and Development (DEPDev formerly NEDA), conducted a joint site inspection of the R.T. Lim–Siocon Road on Thursday, May 22, 2025. The project is a major subcomponent under the Improving Growth Corridors for Mindanao Road Sector Project (IGCMRSP) spanning the provinces of Zamboanga Sibugay and Zamboanga del Norte.
DPWH Secretary Manuel M. Bonoan, together with ADB Vice-President for East and Southeast Asia and the Pacific Scott Morris, led the inspection and expressed optimism about the project’s nearing completion. The road is part of the President Ferdinand R. Marcos, Jr. administration’s “Bagong Pilipinas” vision and the Build Better More infrastructure program.
Also present during the site visit were DPWH Senior Undersecretary Emil K. Sadain, who oversees Official Development Assistance (ODA)-funded infrastructure flagship projects, and Undersecretaries Eugenio R. Pipo Jr. and Carlos G. Mutuc.
The inspection team included Undersecretary Joseph Capuno, Assistant Secretary Roderick Planta, and Director Aldwin Urbina from the DEPDev; Undersecretary Joven Balbosa and Assistant Secretary Donalyn Minimo from DOF; and DPWH officials including Project Directors Teresita V. Bauzon and Benjamin Bautista, retired Project Director Sharif Madsmo H. Hasim, Stakeholders Relations Service Director Randy R. Del Rosario, Regional Office 9 Director Cayamombao D. Dia, and Assistant Regional Director Soray’yah M. Ibrahim.
From ADB, the delegation included Director General for South East Asia Winfried Wicklein, Country Director Pavit Ramachandran, Transport Director Dong Kyu Lee, Transport Specialists Juan Gonzales and Faela Sufa, Incoming Country Operations Head for the Philippines Joros Van Etten, Advisor for the office of the East Asia Director Genera Kelly Bird, Environmental Specialist Syed Asim Ali Sabzwari, and Lead Project Officer (Infrastructure) Atty. Ruby Alvarez.

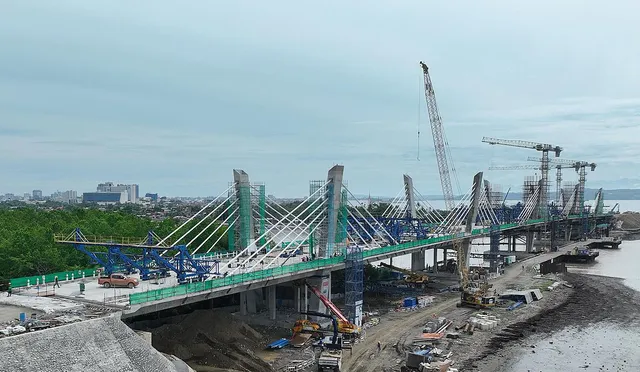

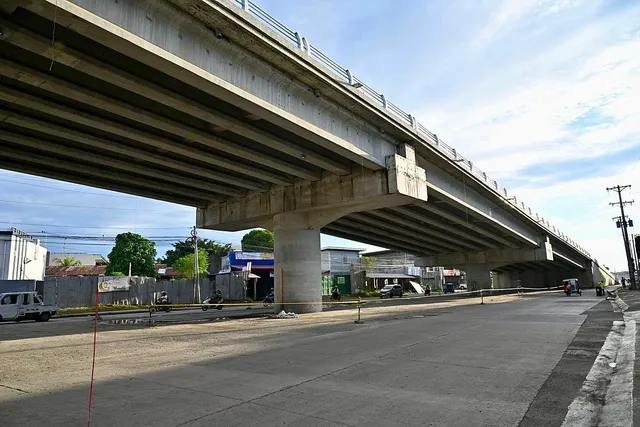

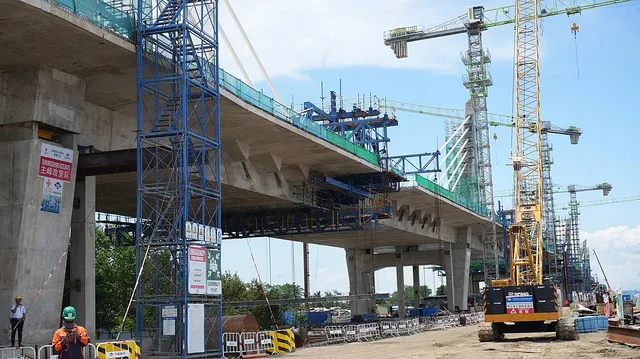

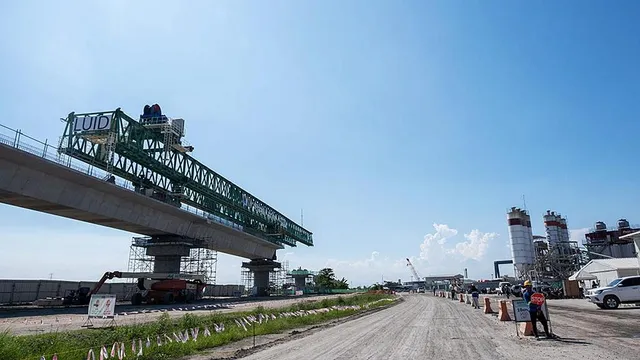

The R.T. Lim–Siocon Road Project, is one of eleven key sub-projects under the 152.61-kilometer IGCMRSP. It includes the construction of 24.03 kilometers of portland cement concrete pavement (PCCP) and six (6) bridges totaling 430.11 linear meters, covering an overall road length of 24.46 kilometers.
“We are pleased to announce that the R.T. Lim–Siocon Road project has officially entered its final stage of civil works. Thanks to the dedication of the Unified Project Management Office - Roads Management Cluster II (UPMO-RMC 2) under Project Director Bauzon, along with our contractor China Wuyi Co., Ltd., consultants, and partners, we are confident the project will be fully completed by this third quarter of 2025”, said Senior Undersecretary Sadain during the chi briefing.
To date, the project is 95% complete, with 23.75 kilometers of PCCP finished and only 0.28 kilometers remaining. Of the six (6) bridges, five (5) have been completed—Kuyan, Lituban, Pisawak II, Tabayo, and another Lituban Bridge—while the Mambong Bridge stands at 93.23% completion.
Funded through ADB Loan No. 3631-PHI, the ₱2.396-billion R.T. Lim–Siocon Road project plays a vital role in enhancing regional connectivity, promoting trade and mobility, and supporting peace and development by linking previously isolated communities through improved road infrastructure.
Secretary Bonoan underscored the broader impact of the project, saying that it not only eases access and mobility but also contributes to building climate-resilient and inclusive infrastructure in Mindanao.
The joint inspection highlighted the ongoing collaboration between the Philippine Government and international development partners like the ADB in delivering transformative, high-impact infrastructure investments that support inclusive growth and sustainable development across the region.

KEY TAWI-TAWI BRIDGE NEARS COMPLETION, BOOSTING INFRASTRUCTURE SUPPORT FOR BANGSAMORO

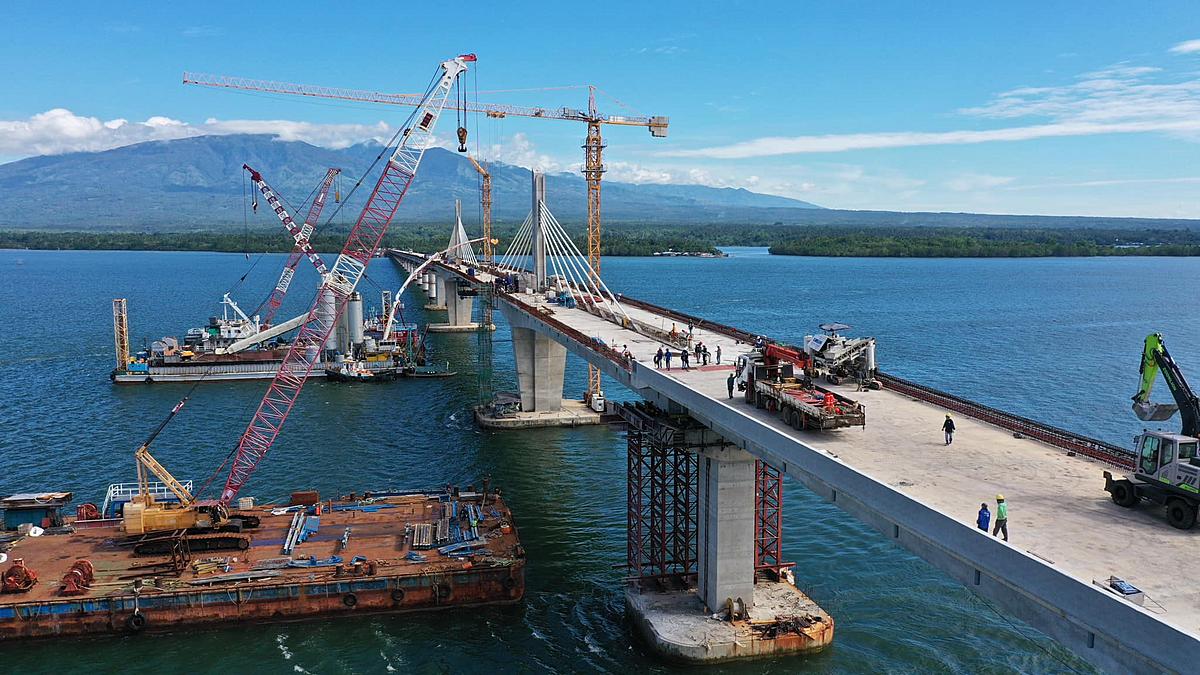

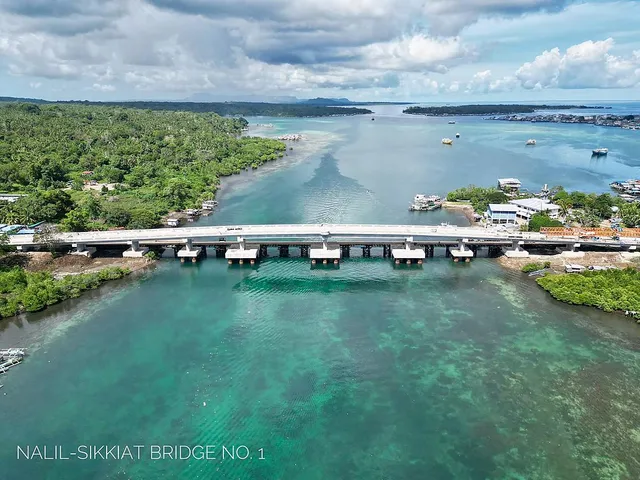

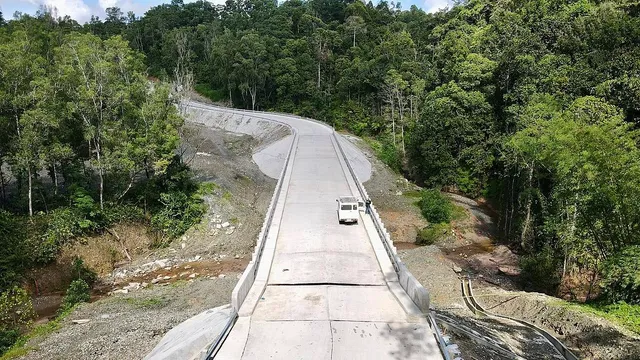

The Department of Public Works and Highways (DPWH) announced that construction of the Nalil-Sikkiat Bridge No. 1 in Tawi-Tawi Province is now 96 percent complete and is scheduled to open by July 2025.
The 541-meter bridge, part of the Asian Development Bank (ADB)-assisted Improving Growth Corridors in Mindanao Road Sector Project (IGCMRSP), aims to connect Bongao Island to Sanga-Sanga Island. It is one (1) of three (3) major bridges in Tawi-Tawi supporting the President Ferdinand R. Marcos Jr. administration’s “Build Better More” program.
“The Nalil-Sikkiat Bridge, along with its sister projects—the Tongsinah-Paniongan Bridge No. 2 and the Malassa-Lupa Pila Bridge No. 3 in Tawi-Tawi—represents one of the most significant infrastructure support initiatives of the national government in the Bangsamoro Autonomous Region in Muslim Mindanao (BARMM). These bridges are more than just structures of physical connectivity; they stand as powerful symbols of the government’s unwavering commitment to fulfilling Mindanao’s long-held promise by unlocking its vast economic potential through modern, inclusive infrastructure,” said Senior Undersecretary Emil K. Sadain who was designated by DPWH Secretary Manuel M. Bonoan to lead the Department’s infrastructure flagship projects under Official Development Assistance (ODA) and BARMM infrastructure initiatives.
DPWH Senior Undersecretary Sadain and ADB Vice President Scott Morris conducted a site inspection at the Nalil-Sikkiat Bridge Project on Friday, May 23, 2025, where they were welcomed by Tawi-Tawi Governor Yshmael "Mang" I. Sali.
The ₱1.08 billion project features a 380.8-meter bridge and a 160-meter approach road. It is being implemented by the Unified Project Management Office – Roads Management Cluster II (UPMO-RMC II), under the leadership of Project Director Teresita V. Bauzon with Project Manager Ernante S. Antonio as project in-charge, and China Wuyi Co., Ltd. as contractor.
Present at the inspection were other ADB executives including Winfried Wicklein, Director General for Southeast Asia; Pavit Ramachandran, Country Director for the Philippines; Dong Kyu Lee, Transport Director; Transport Specialists Juan Gonzales and Faela Sufa; Joros Van Etten, Incoming Country Operations Head for the Philippines; Kelly Bird, Advisor to the East Asia Director General; Syed Asim Ali Sabzwari, Environmental Specialist; and Atty. Ruby Alvarez, Lead Project Officer (Infrastructure).
From the Department of Economy, Planning, and Development (DEPDev, formerly NEDA) were Undersecretary Joseph Capuno, Assistant Secretary Roderick Planta, and Director Aldwin Urbina. Representing the Department of Finance (DOF) were Undersecretary Joven Balbosa and Assistant Secretary Donalyn Minimo.
Also in attendance were other DPWH officials including UPMO-Roads Management Cluster I Project Director Benjamin A. Bautista, former UPMO-RMC II Project Director Sharif Madsmo H. Hasim, Stakeholders Relations Service (SRS) Director Randy R. Del Rosario, BARMM Regional Project Management Office OIC-Director Eileen Diya, and Project Managers Emmanuel M. Supe and Evangeline L. Carabal.
In his report to Secretary Bonoan, Senior Undersecretary Sadain stated that two (2) other bridge components under IGCMRSP are also making steady progress, contributing to the overall momentum of infrastructure development in the Tawi-Tawi.
The Malassa-Lupa Pila Bridge No. 3, which spans 680 meters across the Manalik Channel, is now 72 percent complete. The project connects Sanga-Sanga Island to mainland Tawi-Tawi and has completed deck slab installation up to Pier No. 3, with ongoing bored piling and fabrication works.
The Tongsinah-Paniongan Bridge No. 2, a 570-meter structure connecting Pababag Island to Sanga-Sanga Island, is in the early phase of civil works, including bored piling and equipment mobilization.
According to Senior Undersecretary Sadain, these bridge projects are crucial for strengthening Tawi-Tawi’s transport system and boosting local industries like fishing and seaweed farming. More importantly, they are part of a broader effort to support peace, stability, and inclusive development in the Bangsamoro.
